9 products in Site Hoarding & Temporary Fencing
Swipe to find yours, then open it for lines, prices and drawings.
Which hoarding does my permit require?
Height and colour are set by whoever issues the permit, not by preference — and they differ by zone within the same emirate. This is what we have been able to establish, and where we have not, it says so.
| Authority | Minimum height | Material | Colour & branding |
|---|---|---|---|
| Dubai Development AuthorityRead at sourceTECOM, Internet City, Media City, Dubai Design District, Barsha Heights | 2.0 m minimum | Corrugated steel | White, with no logos or artwork. Within the plot, or up to 3.0 m outside it. Circular 331 of 29 September 2019, "Standardization of Signboard and Hoarding at Site". |
| Dubai Development Authority — Healthcare CityRead at sourceDubai Healthcare City plots only | Not specified | Corrugated steel | Dark green, with no logos or artwork. The 2008 circular is still live. |

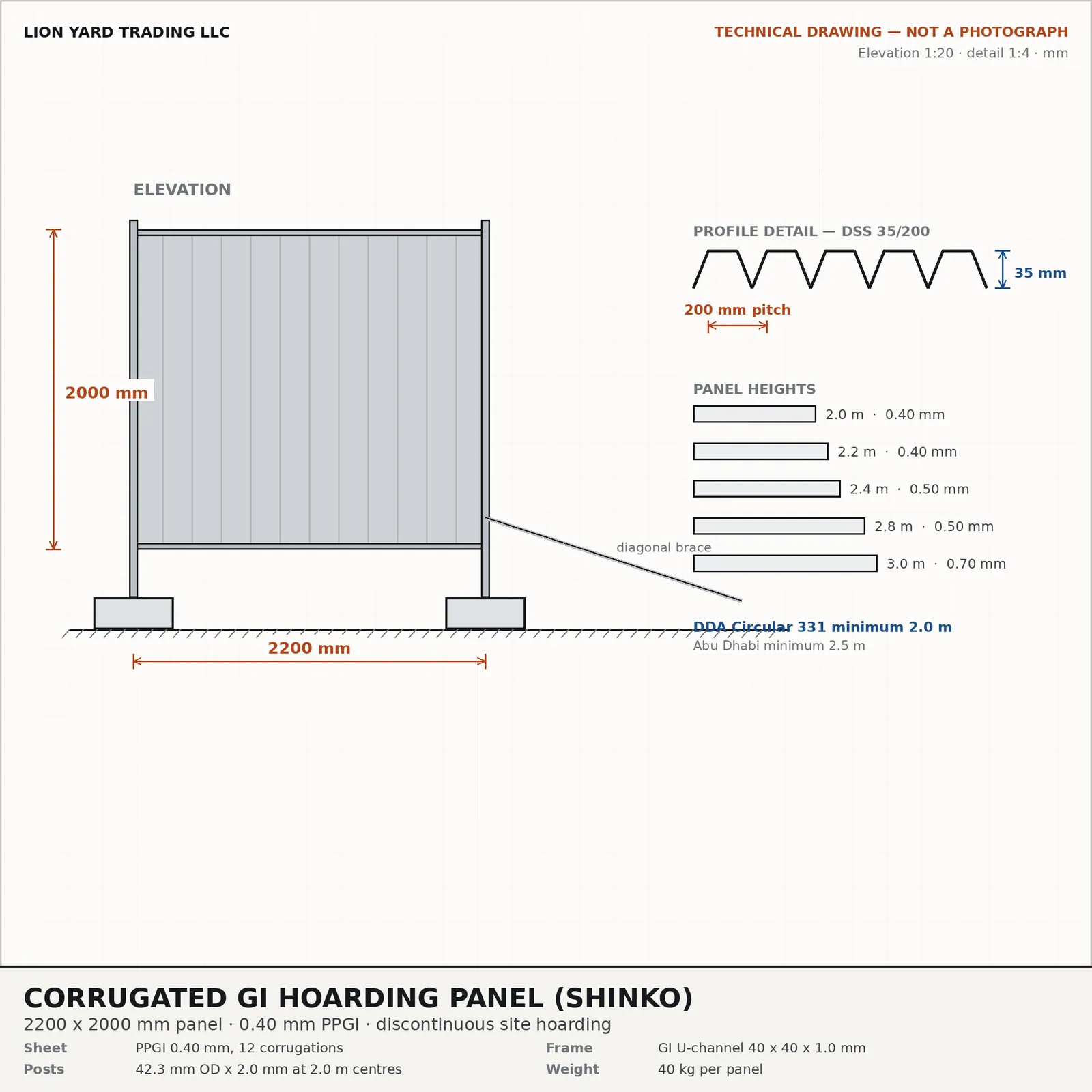

| Abu Dhabi MunicipalityTrade consensusAbu Dhabi mainland plots | 2.5 m minimum | Iron sheets on a steel frame, in concrete bases | Bright orange or an approved colour. Panel gaps 5 cm or less, ground gap 20 cm or less, site entrance under 5 m wide.The height, gate width and colour are consistent across independent reporting. The 5 cm and 20 cm gaps are not: they trace to a single press account whose wording — five centimetres between the poles — cannot be read literally of a fence, and this is our reading of what was meant. We have not read the municipality's own circular. Ask us before you build to the gap figures. |

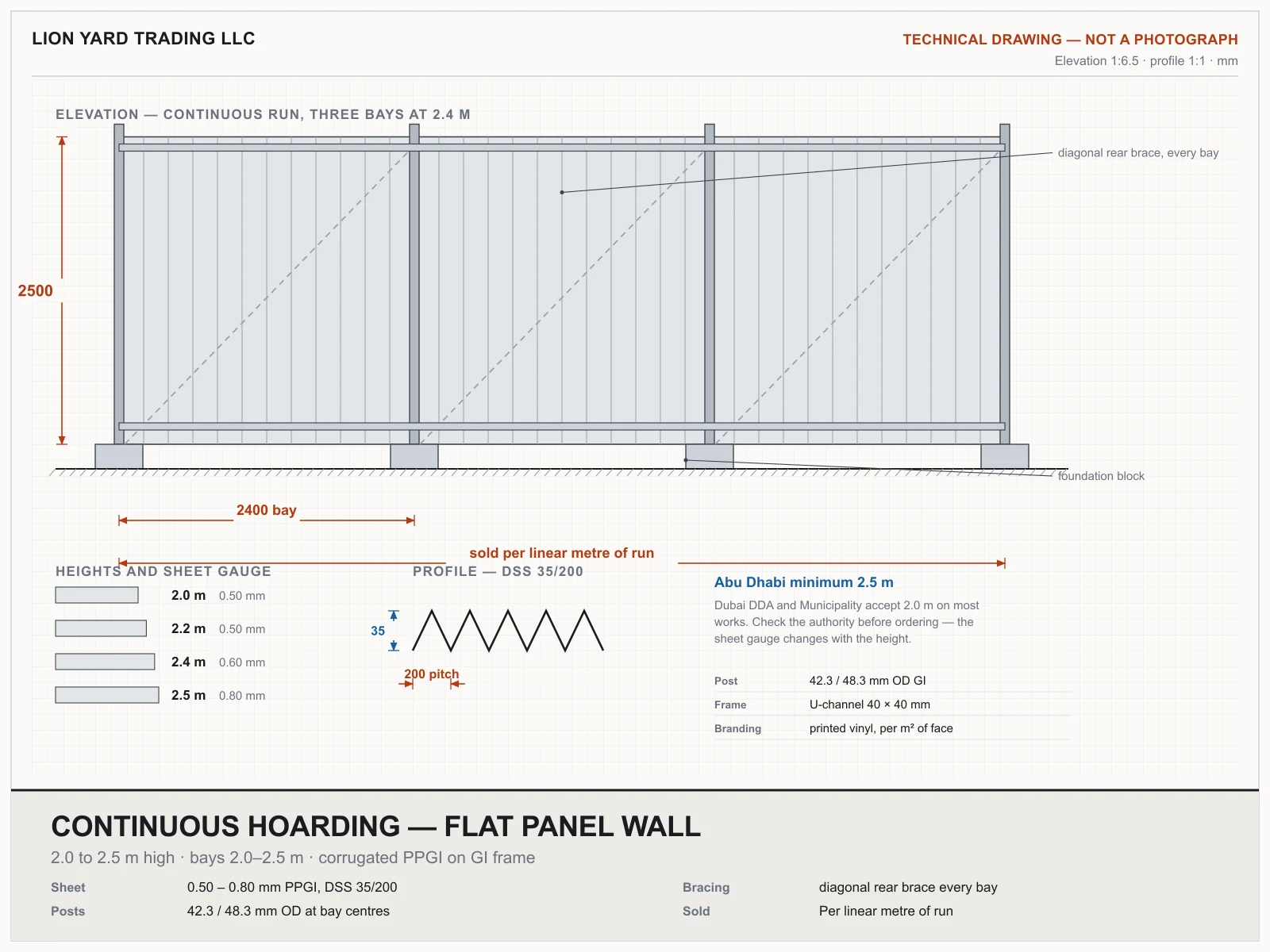

Branding is prohibited in DDA zones, not required. Circular 331 specifies white hoarding with no logos or artwork, and Dubai Healthcare City specifies dark green. If somebody has told you a premium developer expects a wrapped marketing banner, check the plot’s authority first — in a DDA zone it will be refused.
What we have not been able to confirm
Published here rather than left out. A supplier who prints a confident figure for every authority has invented some of them.
- Dubai MunicipalityNot establishedDubai mainland plots outside the free zones
Chapter 6 of the Code of Construction Safety Practice governs this, and we have not been able to read it at source. The 2.4 m figure quoted across the trade traces only to supplier blogs — most likely the 8 ft sheet length become a habit. Ask us and we will confirm with DM before you order.
- Trakhees / PCFCNot establishedPalm Jumeirah, Jebel Ali, the Nakheel zones
Regulation CS-4.0 is published only as a scanned document and no clause could be extracted. Anyone quoting you a Trakhees rule is not citing a document we could find.
- Sharjah & the northern emiratesNot establishedSharjah, Ajman, Umm Al Quwain, Ras Al Khaimah, Fujairah
Sharjah requires a fence permit; Ras Al Khaimah's building code covers permanent fences only. No temporary hoarding dimension could be established for these emirates.
Work out your run
Perimeter, corners and openings in — panels, posts, blocks, braces and clamps out. The arithmetic is shown so you can check it against your own take-off.
| Item | Qty |
|---|---|
| Hoarding panel 2.2 × 2.4 m — 0.50 mm | 46 panels |
| GI post 3.0 m | 53 pieces |
| Foundation block — standard | 55 pieces |
| Diagonal brace pipe 2.0 m | 61 pieces |
| GI clamp / coupler 3.0 mm | 124 pieces |
Panels = perimeter ÷ 2.2 m, rounded up. Our panel is 2.2 m long — a rule that divides by 2.0 over-orders by about a tenth.

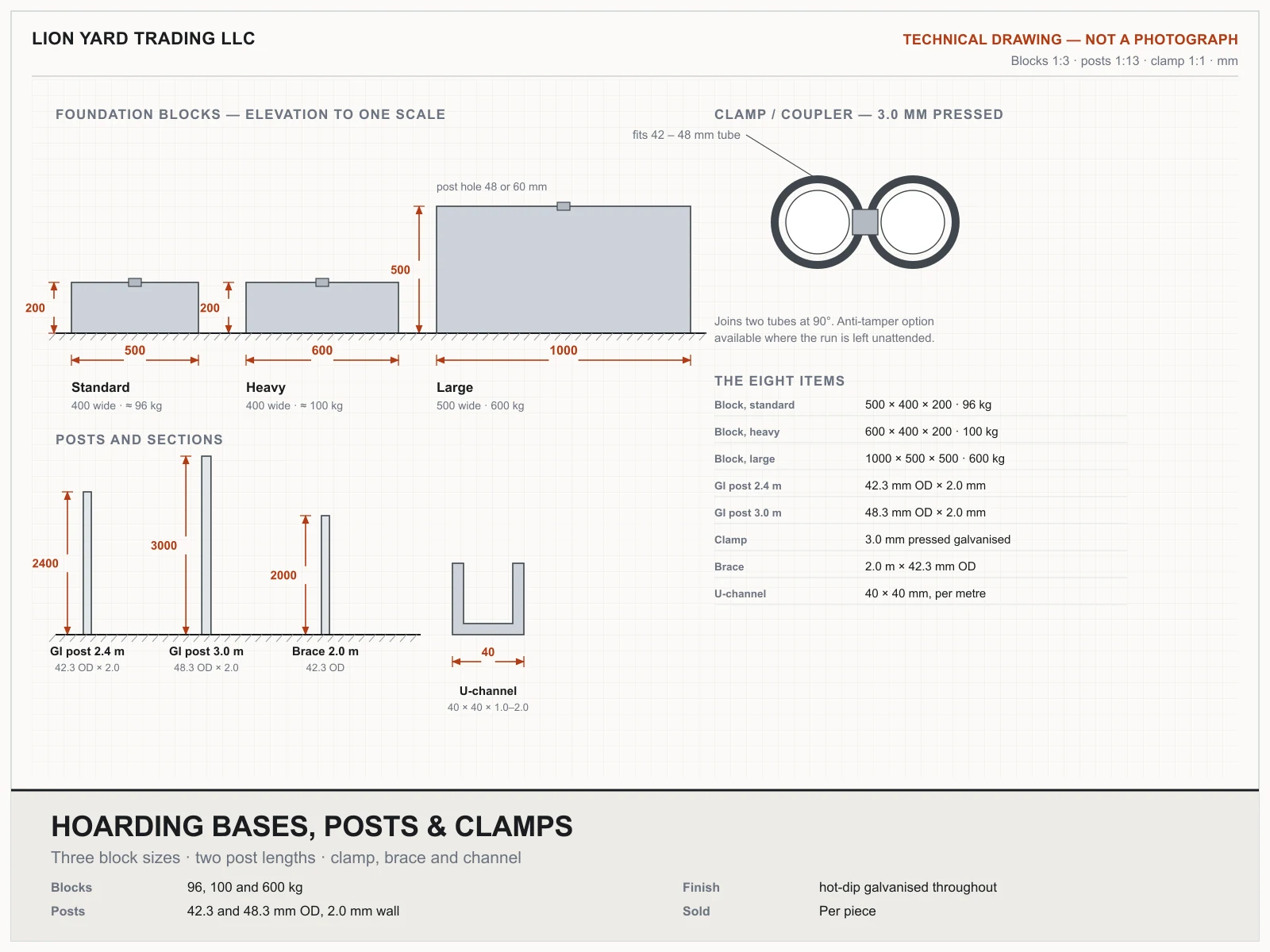

Posts = panels + 1 to close the run, + 1 per corner, + 2 per gate opening.
Blocks = one per post, doubled at gate posts. Braces = one per post, + 2 diagonals per corner.
Clamps assume two per brace, one at each end — change it if your detail differs.
An estimate from published part sizes, not a structural design. Wind loading, ground conditions and the authority’s own requirements are confirmed at survey.

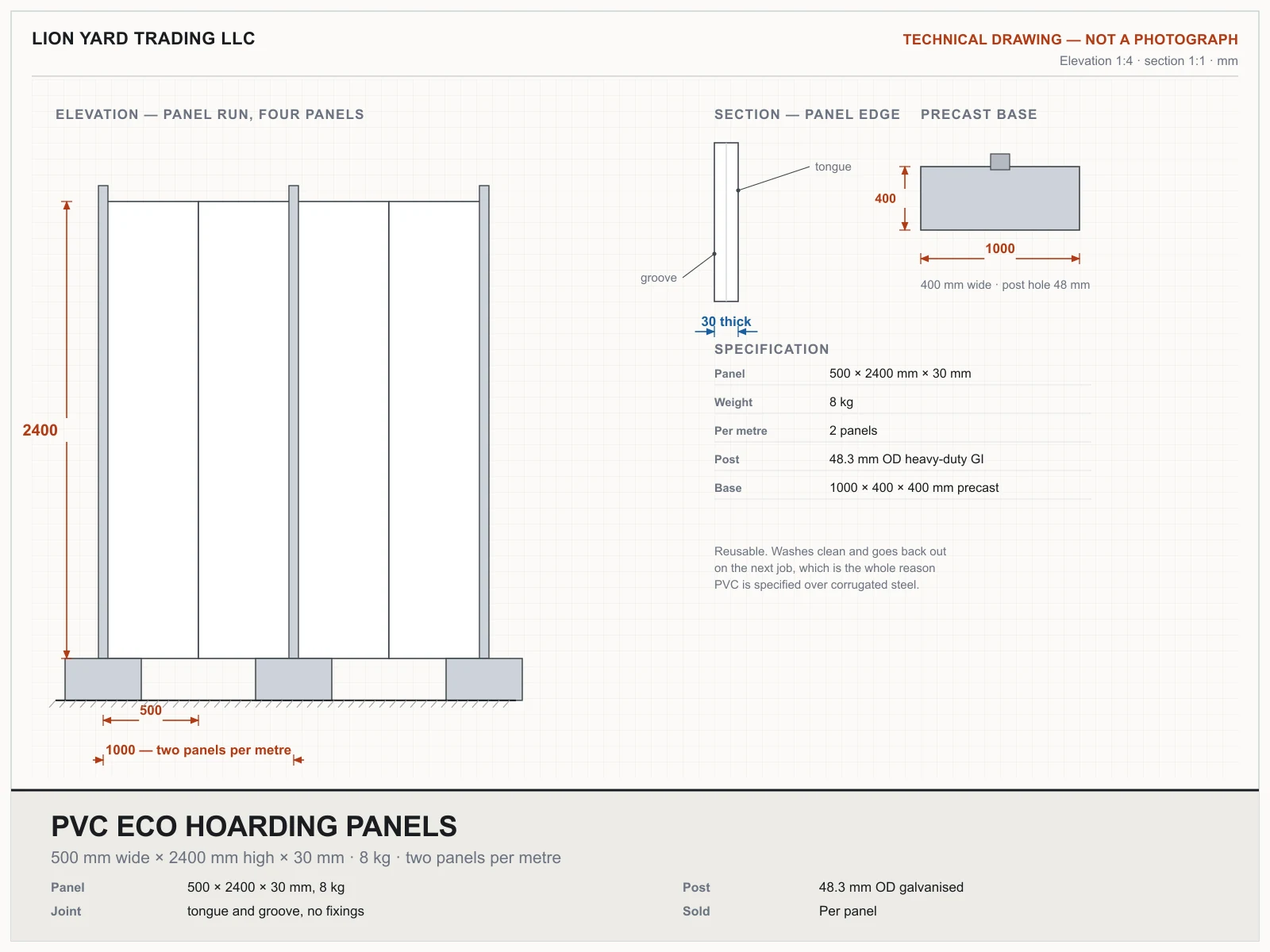

Hoarding panel 2.2 × 2.4 m — 0.50 mm — 46 panels GI post 3.0 m — 53 pieces Foundation block — standard — 55 pieces Diagonal brace pipe 2.0 m — 61 pieces GI clamp / coupler 3.0 mm — 124 pieces
Where this is used.
The jobs site hoarding & temporary fencing actually do. If yours is not on the list, it is still worth asking — most of what we supply ends up somewhere nobody wrote down.
Plot enclosure before work starts
The permit condition that comes before everything else — the boundary has to stand, at the height and colour the authority for that plot specifies, before the first delivery arrives.
Road frontage & pedestrian diversion
Where the site meets a footpath or carriageway, and the enclosure is also what keeps the public out of the works.
Phased handover
Hoarding moved inwards as zones complete, so the finished part opens while the rest stays enclosed. Panels come back to us and go out again on the next job.
Events & changing internal layouts

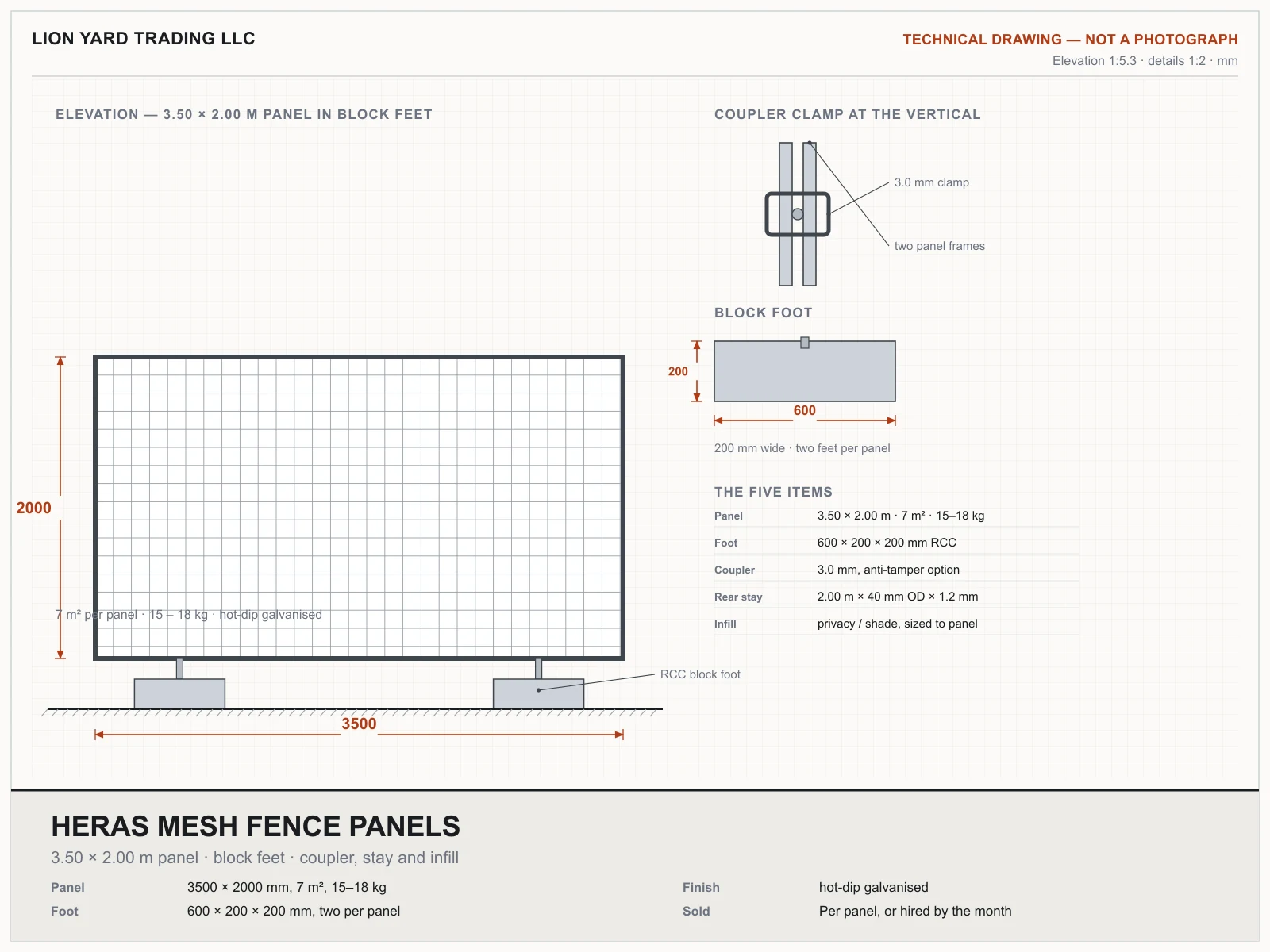

Heras panels in loose feet, moved by two men in minutes, for crowd routing and site areas that change week to week.
Dust, sand & visual screening

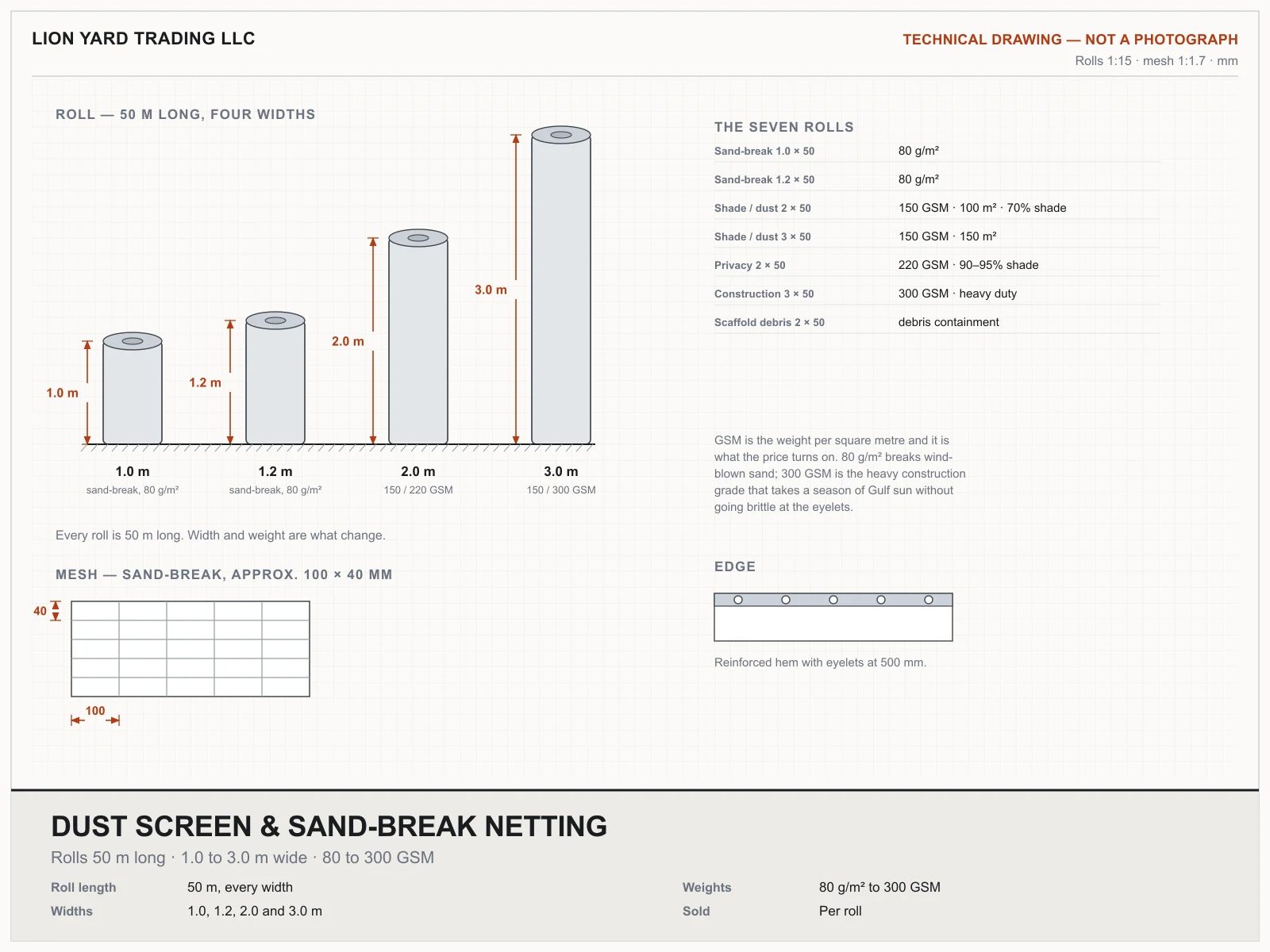

HDPE netting over the enclosure where the works have to be kept out of the wind, out of the neighbours' air, or out of sight from the road.
Site entrances

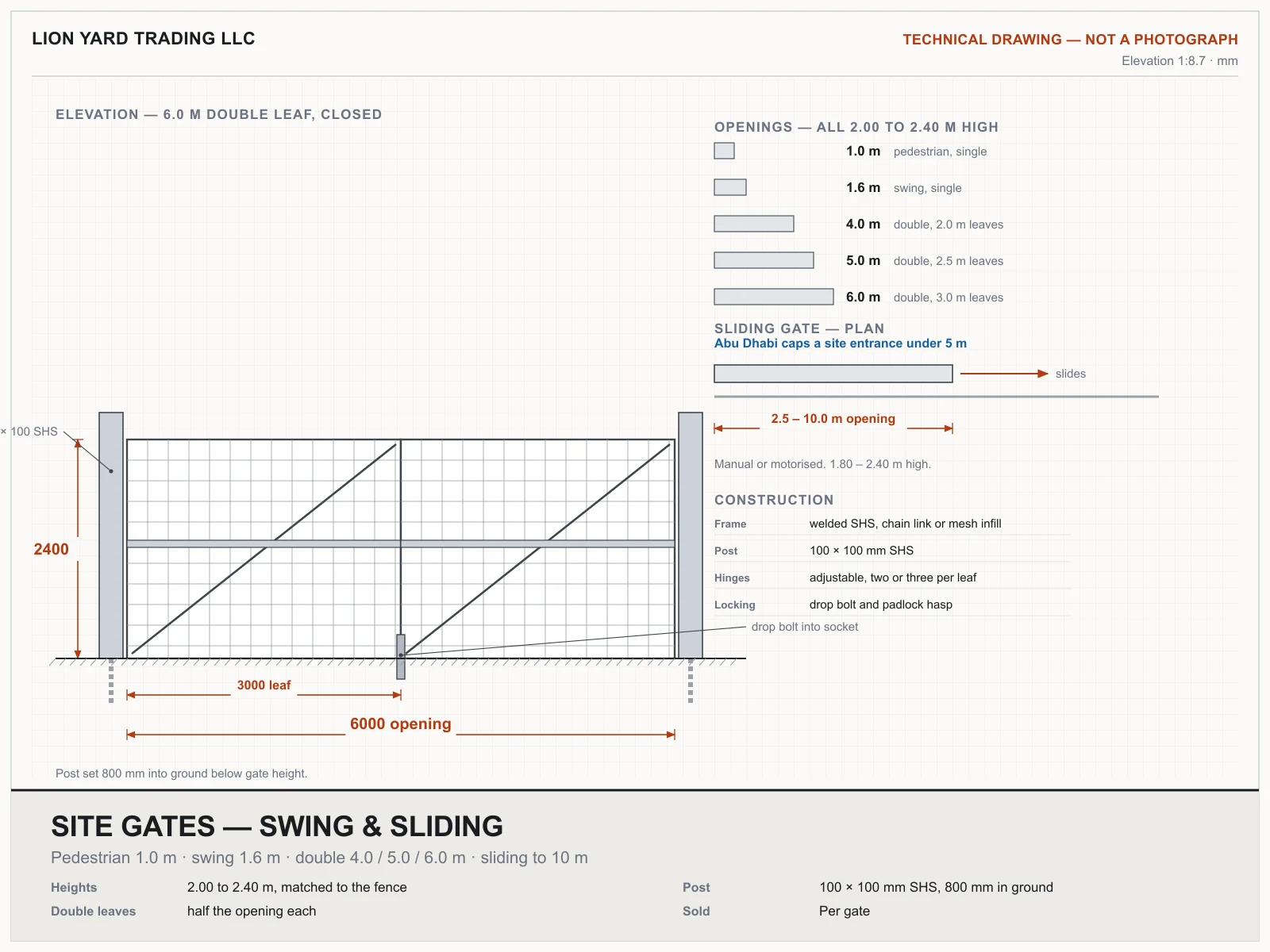

Vehicle and pedestrian gates matched to the run. Abu Dhabi caps a site entrance at under 5 m, which decides the leaf sizing before anything else.
What we can put in front of your engineer.
Ask for any of it against a specific size and you will get it the same working day.
- Panel height, sheet gauge and weight per panel, so you can check it against the permit condition
- Which authority governs your plot, and what it specifies for height, material and colour
- How many blocks, posts, clamps and braces a given run length needs
- Stocked RAL colours, and which one the plot's authority will accept
We do not publish downloadable datasheets. Where a standard or a certificate is written into your specification, ask us against the specific unit — we will either produce the supplier documentation or tell you plainly that we cannot, rather than leave you to find out at inspection.
What you get with the price.
Stock on the ground
Same-day into Sharjah and the northern emirates for what is in the yard, one to three working days elsewhere.
New and refurbished
Both grades priced side by side on every line, so the budget decision is yours to make, not ours to steer.
Delivered and offloaded
Our own transport across all 7 Emirates, with crane or forklift offloading arranged and quoted before you commit.
Checked before it leaves
Refurbished units are cleaned, repaired and inspected in our own yard rather than shipped on as found.
Bulk and project supply
Send the full requirement rather than line by line — contractor and bulk rates are better than list.
Straight answers
If we cannot meet a specification or evidence a standard, we say so at enquiry stage rather than after the order.
Specifying site hoarding
The permit decides your height and your colour. Everything after that is a choice, and the one that costs most to get wrong is ordering panels without the blocks, posts and clamps that make them stand up.
